Since its incorporation in 1960, the unprecedented growth of San Dimas has transformed the City from an essentially rural area to a well-balanced community offering industrial, commercial, and residential living. In addition to the 1,700 acre Frank G. Bonelli Recreational Area which lies within the City boundaries, there are many parks such as San Dimas Canyon Park, a city-owned golf course (San Dimas Canyon Golf Club), and over 27 miles of equestrian trails for riding. The city services include an extensive recreational program for youth and for senior citizens, and the City boasts a new modern City Hall, with excellent provisions made for County Sheriff and Fire Departments, along with a fine Los Angeles County Library and Engineering Regional Office.
Recently Completed Projects

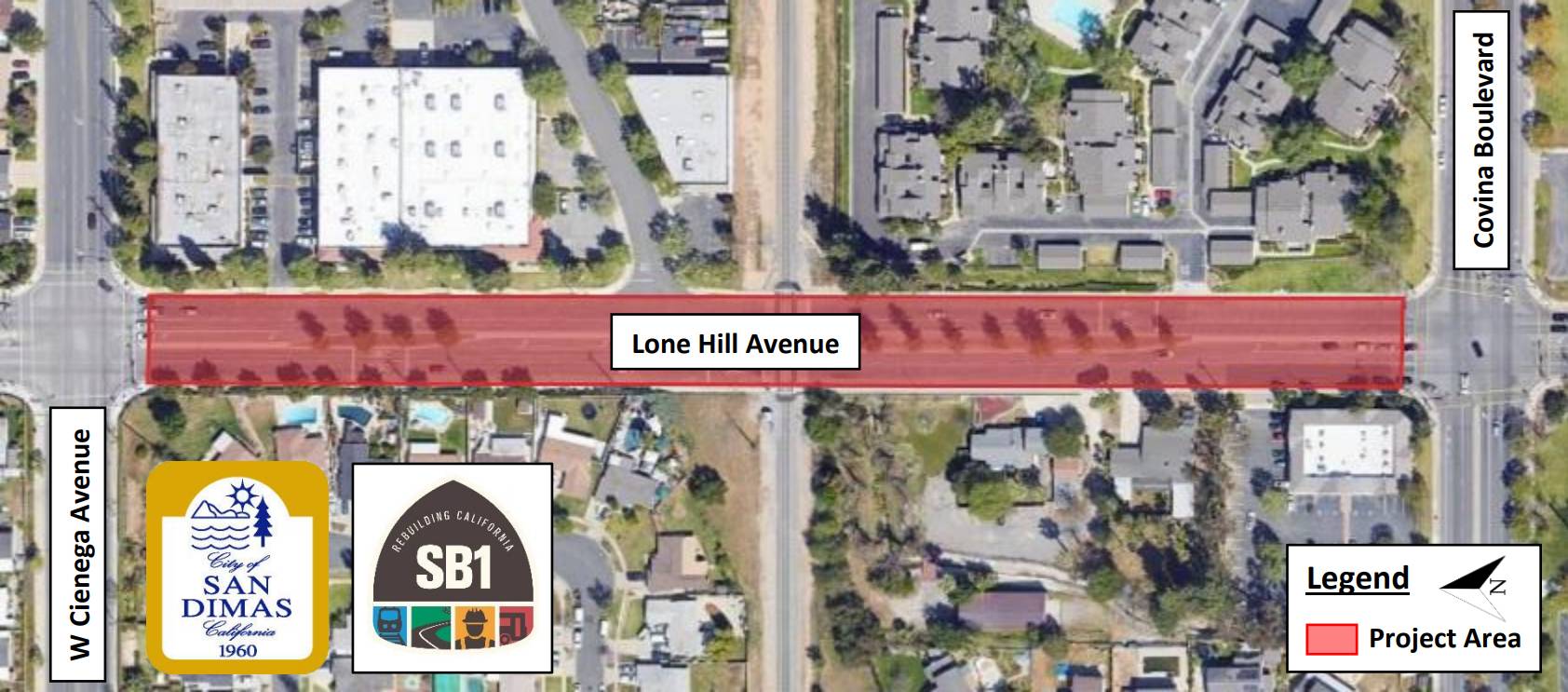

CC2024-02 Lone Hill- Street Improvement Project
The SB1 Funded Lone Hill Avenue Street Improvement Project reconstructed Lone Hill Avenue between Covina Boulevard and W Cienega Avenue, providing reduced future maintenance costs, increased safety, and an aesthetically pleasing, smoother, and quieter street surface for residents for decades to come. This project reconstructed approximately 97,000 square feet of pavement using approximately 4,700 tons of asphalt concrete. Along with the street rehabilitation, this project replaced minor curb, gutter, sidewalk panels, and corner ramps to improve accessibility.
Construction Notice

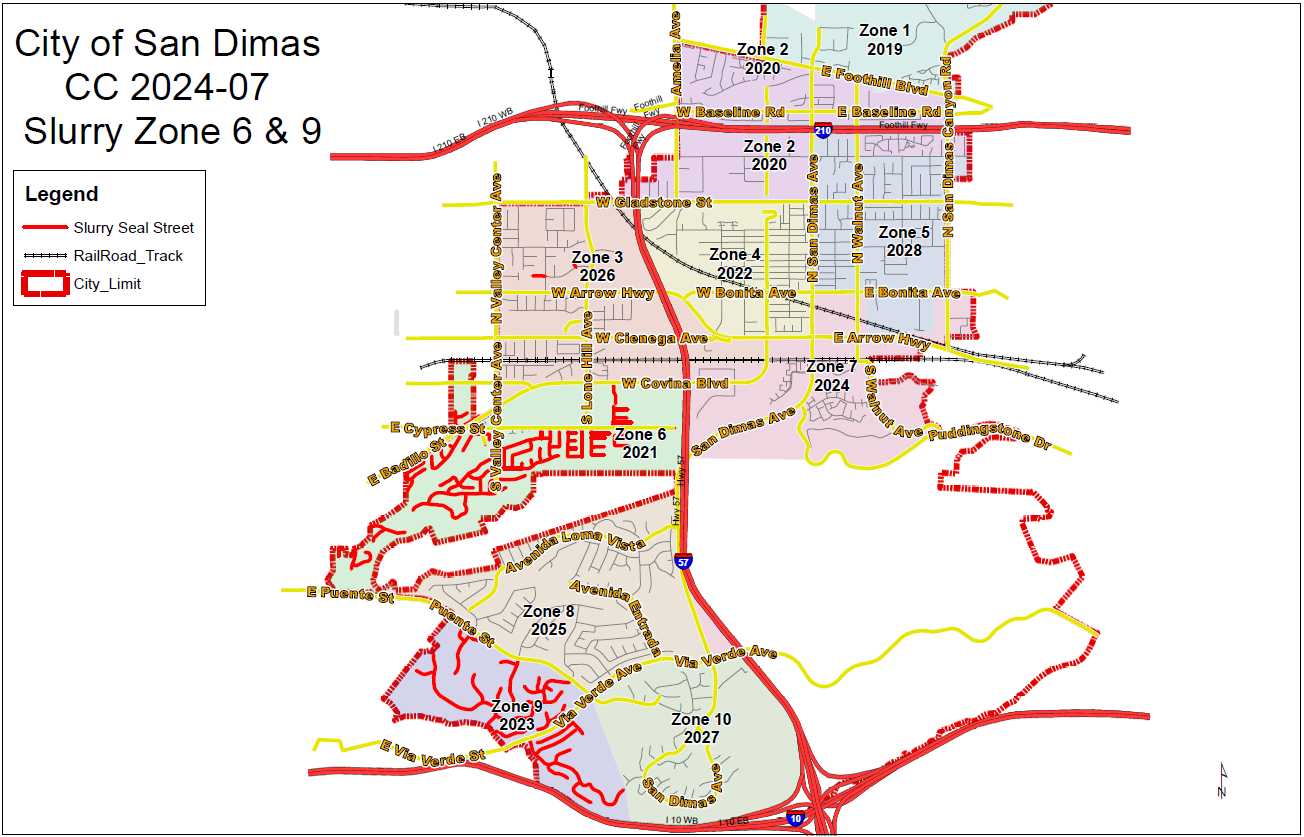

CC2024-07 Slurry Zone 6 & 9
The Slurry Seal Maintenance Project will provide pavement maintenance for approximately 3,800,000 square feet of asphalt pavement. The City utilizes a pavement management program to schedule routine maintenance of residential streets which is designed to minimize the cost of ongoing street maintenance. This project was awarded by City Council to Roy Allen Slurry Seal Inc to place crack seal on various city streets followed by slurry seal. The project concluded with new traffic striping. The Slurry Seal application helps preserve and protect the underlying pavement structure and provides a new driving surface. The entire project cost $1 Million and construction was completed in early November 2024.
Construction Notice

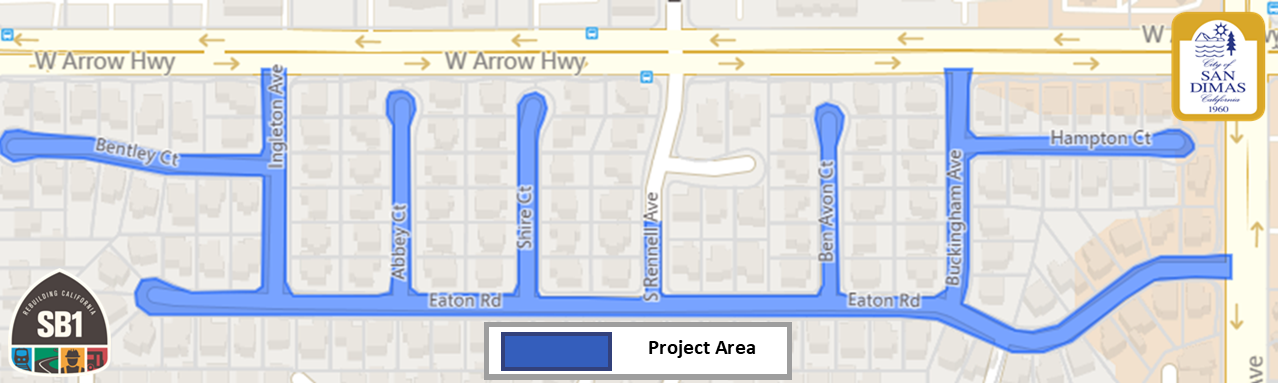

Project Description
The SB1 Funded Eaton Road Et Al Street Improvement Project reconstructed approximately 190,000 square feet of pavement using approximately 3,200 tons of asphalt concrete. This project rehabilitated eight residential streets: Bentley Ct., Ingleton Ave., Abbey Ct., Shire Ct., Ben Avon Ct., Hampton Ct., Buckingham Ave., and Eaton Rd. This will provide an aesthetically pleasing, smoother, and quieter street surface for many years. Along with the street rehabilitation this project replaced minor curb, gutter, sidewalk panels and corner ramp upgrades improving accessibility.
This project incorporated environmentally friendly and cost-effective rubberized asphalt pavement which incorporates used automobile tires into our pavement design. This process will divert approximately 4,200 California automobile tires from going directly into a landfill while significantly improving the performance of our roads including the reduction of pavement cracking, longer lasting more resilient pavement and reducing pavement noise.
CC2023-05 Billow Dr and Pearlanna Dr - Street Improvement Project

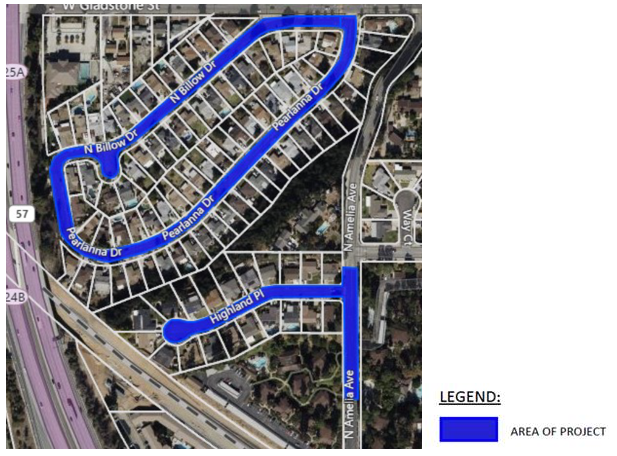

Project Description
The City of San Dimas awarded a contract to Sequel Contractors Inc to rehabilitate the roadway on Billow Drive, Pearlanna Drive, Highland Place and Section of Amelia Avenue (From 5th Street to 500’ South of 5th Street intersection). The overall project is estimated to cost $600,000. The improvements will provide both an aesthetic enhancement to the neighborhood and improve access for residents.
CC2022-06 Via Verde Street Improvement Project

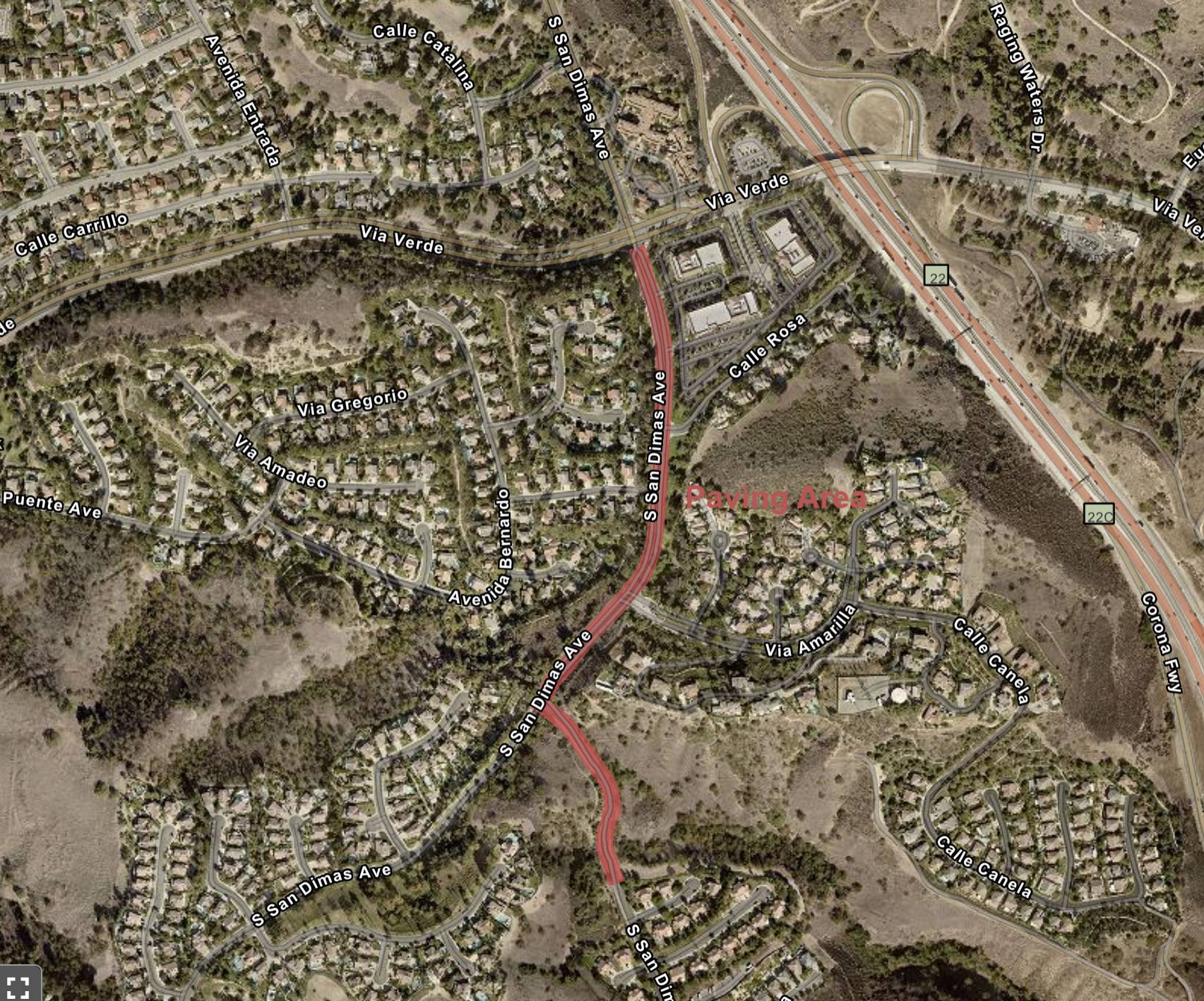

Project Description
The City of San Dimas awarded a contract to Sully-Miller Contracting Company to reconstruct the roadway on Via Verde from 500’ west from the 10-FWY on/off ramp intersection to the 57-FWY on/off ramp intersection. The improvements will provide both an aesthetic enhancement to the neighborhood and improve access for residents. Project improvements included: concrete improvements including ADA curb ramps, curb & gutter, sidewalks and driveway approaches. Rehabilitation of the asphalt pavement section will provide an aesthetically pleasing, smoother and quieter street surface for many years.
CC2022-05 Via Vaquero et al Street Improvement Project
Project Description
The Via Vaquero et al Street Improvement Project reconstructed approximately 150,000 square feet of pavement using approximately 4,250 tons of asphalt concrete. The project rehabilitated Via Vaquero West of San Dimas Avenue including all connecting public streets. This project will provide an aesthetically pleasing, smoother, and quieter street surface for many years. Along with the street rehabilitation the project replaced minor curb, gutter, sidewalk panels and corner ramp upgrades improving accessibility. The project cost approximately $1.4 million and of that cost $300,000 is SB 1 Road Maintenance and Recovery Act of 2017 funded (Gas Tax). The new pavement’s estimated useful life is 20 to 25 years.
CC2022-03 Derby Road, Kent Street & Leed Court Street Improvement Project
CC 2021-03 Covina et al Street Improvement Project
Project Description
The Covina Boulevard et al Street Improvement Project reconstructed approximately 325,000 square feet of pavement using approximately 9000 tons of asphalt concrete. The project rehabilitated Covina Boulevard between Arrow Highway and the 57 freeway on/off ramps providing an aesthetically pleasing, smoother, and quieter street surface for many years. Along with the street rehabilitation, the project replaced minor curb, gutter, sidewalk panels and corner ramp upgrades improving accessibility.
When feasible this project used environmentally friendly and cost-effective construction processes including Full-Depth-Reclamation (FDR) which recycles the existing asphalt concrete and underlying aggregate base/soil material. The existing pavement was pulverized or crushed, mixed with cement, and rolled into a stronger sub-base; left to cure for up to five days per lane and closed to vehicle traffic. Following the cure time, the new asphalt concrete pavement was constructed. The project cost approximately $2 million and of that cost $600,000 is SB 1 Road Maintenance and Recovery Act of 2017 funded (Gas Tax). The new pavement’s estimated useful life is 20 to 25 years.
Civic Center Park Lighting and Sidewalk Project
Project Description
CC2018-03 San Dimas Avenue Et Al Pavement Rehabilitation Project Including the Antonovich Trailhead Parking Lot
CC2018-03 San Dimas Avenue Et Al Pavement Rehabilitation Project is a super project that combines pavement rehabilitation of San Dimas Avenue from Via Verde Avenue to Puddingstone Drive, pavement reconstruction of Puente Avenue from Via Verde Avenue to Via Palomares and construction of parking lot improvements on the Antonovich Trailhead (Los Angeles County to reimburse the City for the cost of parking lot improvements).
CC2018-02 Golden Hills Road Reconstruction/Realignment Project
**The new roadway alignment is in gold in this image.
Project Description
CC2018-05 Juanita Et Al Street Improvement Project:
Project Description
